The A to Z of P2X Projects

March 10, 202610 min read
Green HydrogenP2XPolicyMarket IntelligenceProject Development

Ekansh Sharma

Founder, HyGOAT | Hydrogen Tracer

The A to Z of P2X Projects

The A to Z of P2X Projects, Rewritten for 2026

Originally published on November 7, 2025. Rewritten on March 10, 2026 to reflect the current market, policy, and certification landscape.

The first version of this article focused on the mechanics of building a P2X project. That part still matters. What changed is the context around it.

Since November 2025, the sector has become less forgiving. Developers can no longer rely on announcement volume, generic "hydrogen hub" narratives, or vague export ambitions. The market now rewards projects that can answer five questions early: who buys the molecule, which certification regime applies, how power is sourced, how carbon intensity is evidenced, and what exactly gets a project to FID.

The 2026 Reset

  • The Hydrogen Council now counts $110 billion of committed investment across 510 projects that are past FID, under construction, or already operational. Committed production capacity is above 6 mtpa, while roughly 1 mtpa is already operational.
  • The IEA is even more blunt: by 2030, only about 4.2 mtpa of low-emissions hydrogen capacity is operating, under construction, or past FID. Another 6 mtpa has "strong potential," but the much larger announced pipeline has been revised down to about 37 mtpa, from 49 mtpa a year earlier.
  • Export optimism has hit reality. The IEA says nearly 45% of announced low-emissions hydrogen supply is aimed at international trade, but only about 5% of export-oriented projects have reached FID.
  • Offtake is still the hardest bottleneck. The Hydrogen Council estimates only 3.6 mtpa of binding offtake had been secured by 2025. The IEA adds that signed offtake announcements slowed in 2024 and only a minority were fully firm.

The old lesson still holds: a P2X project does not become real when it is announced. It becomes real when demand, power, permits, contracts, and Certification line up at the same time.

The Lifecycle Still Matters

A P2X project is still a sequencing problem. The order matters more than the technology buzzwords.

1. Start with the buyer, not the electrolyzer

The first serious question is not "which stack?" It is "which molecule, for which customer, under which regulatory regime?"

If the answer is not clear, the project is still a concept note.

For 2026, that means deciding early whether the project is designed for:

  • domestic GHCI compliance in India,
  • RFNBO eligibility for Europe,
  • Japan's support-backed clean hydrogen demand,
  • Korea's clean hydrogen power market,
  • or a derivative market such as green ammonia or green methanol.

2. Feasibility is now a compliance exercise

Land, water, and renewable power still matter. But feasibility now also means proving that the power strategy and data model can survive an audit.

A project that wants export optionality has to think through Carbon Intensity, metering, traceability, and auditability before Pre-FEED is over. Retrofitting that later is expensive and often delays commercial timelines.

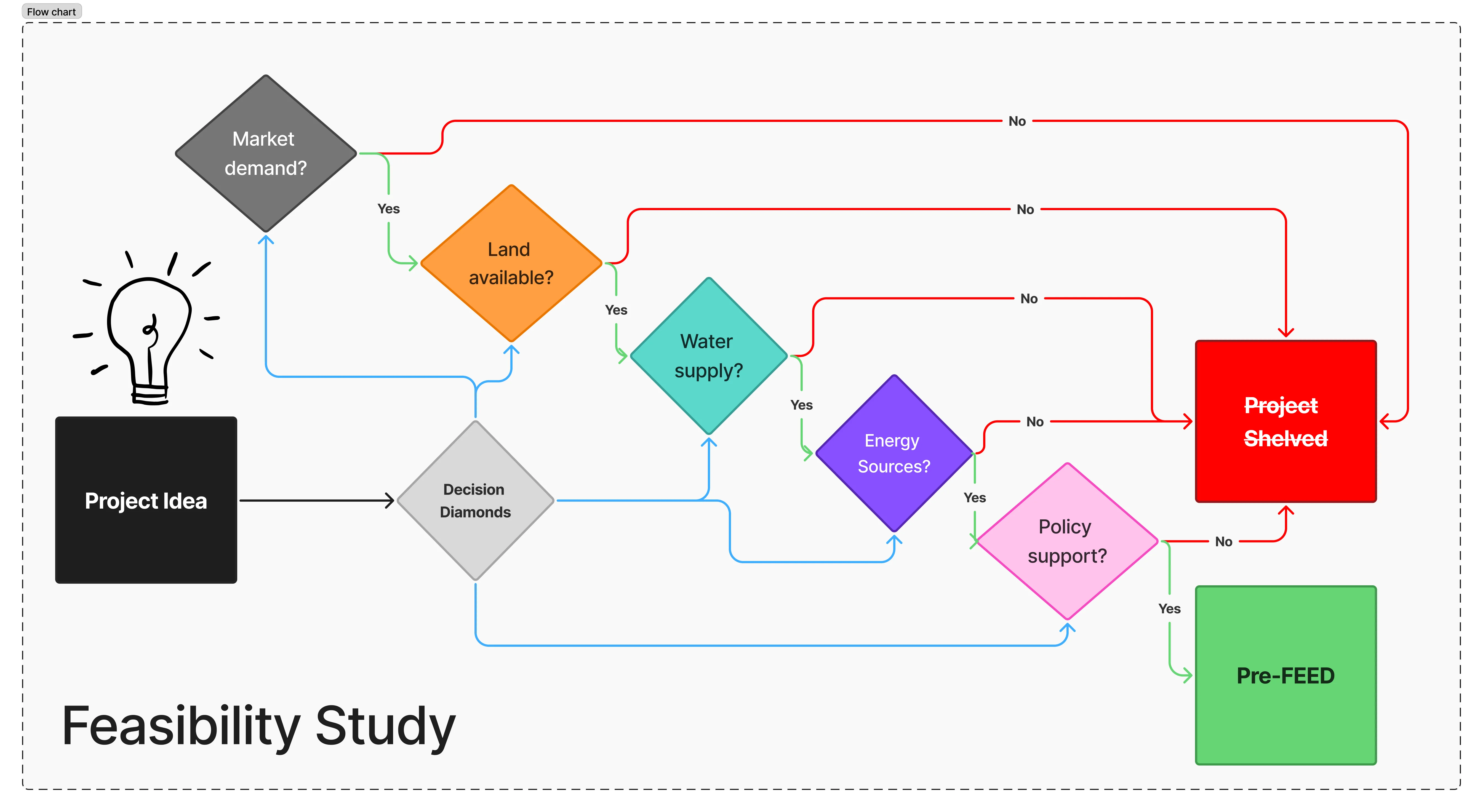

Five Critical Decision Points for P2X Project Feasibility

Five decisions still kill most projects early: site, water, renewable power, customer commitment, and financial viability.

3. The timeline is still measured in years, not quarters

The exact duration varies by market, derivative, and grid context, but the broad pattern is stable:

  • 0 to 6 months: concept screening and demand validation
  • 6 to 18 months: site work, commercial structuring, early permits, power strategy
  • 18 to 30 months: Pre-FEED, FEED, vendor selection, contract negotiation
  • 30 to 42 months: procurement and construction
  • 42 to 54 months: commissioning, performance testing, and ramp-up

That is why policy windows and buyer procurement cycles matter so much. Many of them move more slowly than startup timelines, but more quickly than project finance cycles.

P2X Project Development Timeline

P2X development is still a multi-year journey. The exact path changes, but the gating logic does not.

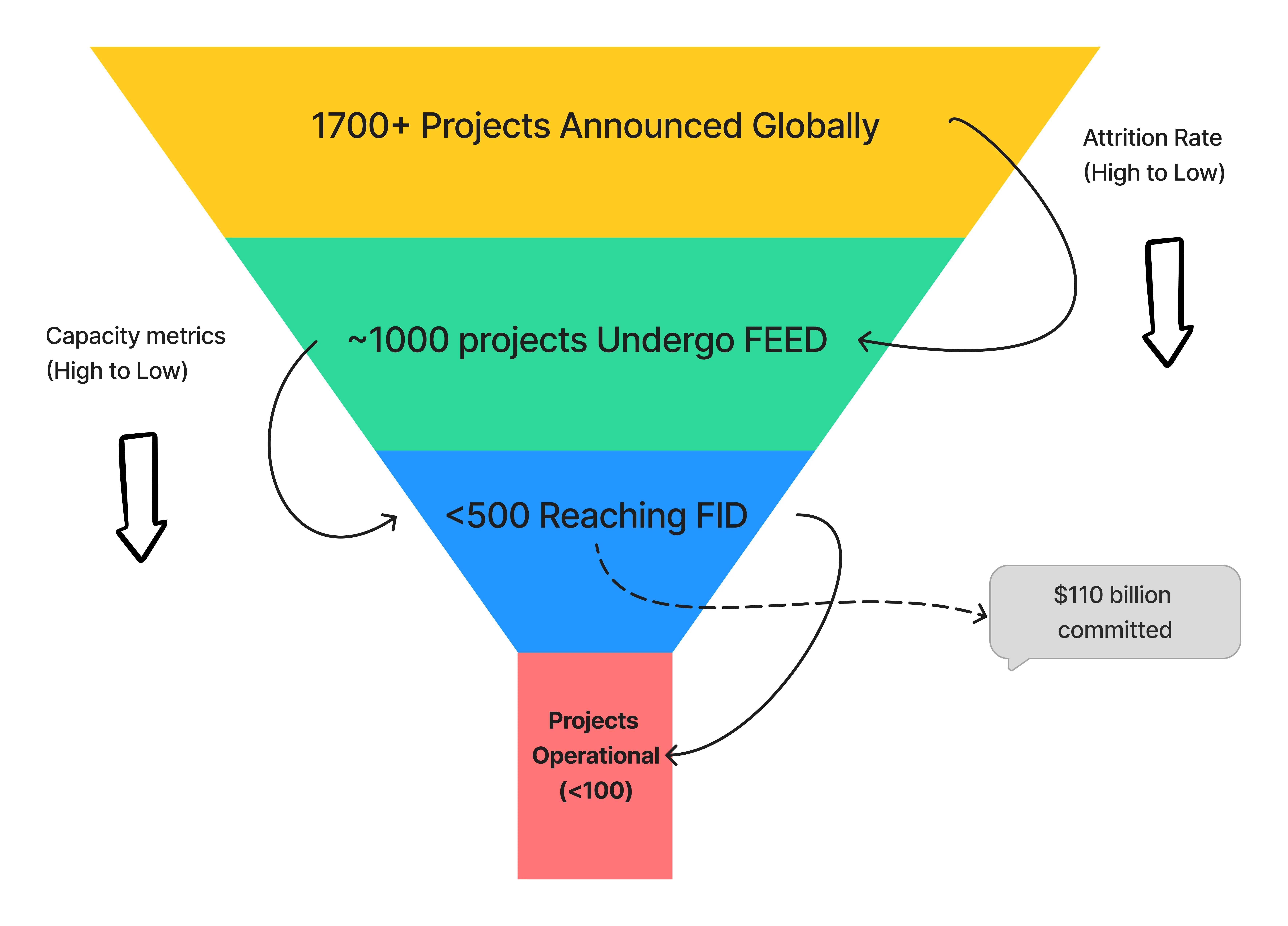

Loading investment scale funnel...

4. FID is still the only milestone that really matters

A project reaches FID when it becomes underwritable. In practice, lenders and investment committees still look for the same stack:

  • contracted demand,
  • contracted or clearly structured renewable power,
  • permit visibility,
  • bankable EPC scope,
  • realistic contingency,
  • and a credible Certification pathway.

The dashboard below is illustrative, but the point is real: FID is not one document. It is the moment every major project risk has a named owner and a financing answer.

Loading FID decision dashboard...

What Changed Since November 2025

The biggest shift is not technical. It is commercial and policy-driven. Demand creation mechanisms are more specific, and compliance regimes are more operational.

MarketWhat movedWhy it matters for developers
EuropeRFNBO remains the strict benchmark. In January 2026, CINEA announced that six winners from the 2024 renewable hydrogen auction signed grant agreements worth about EUR 270.6 million, backing roughly 381 MW and around 500 kilotonnes of renewable hydrogen output over ten years. The third European Hydrogen Bank auction closed on February 19, 2026 with a EUR 1.3 billion budget.Europe is moving from framework to allocation. If a project wants EU-linked upside, its power matching, additionality logic, and proof systems have to work in detail.
EuropeThe European Commission's Hydrogen Mechanism launched its first matching round in 2025 and reported supply interest from 260+ projects. The current offtake collection window runs until March 20, 2026.This is an early market-making signal: developers need buyers and trading structures, not just production ambition.
H2GlobalHintco launched the second H2Global auction on February 19, 2025 with at least EUR 2.5 billion, then expanded regional lot funding and extended key deadlines on September 22, 2025.The market for derivatives like ammonia is increasingly shaped by demand support architecture, not just commodity cost curves.
IndiaIndia's GHCI threshold of 2 kg CO2e/kg H2 is now embedded in the mission architecture. Government updates also point to 862,000 tonnes per year of annual green hydrogen production allocations, 3,000 MW of electrolyzer manufacturing allocations, and mobility pilots covering 37 vehicles, 9 refuelling stations, and 10 routes.India is no longer just an "ambition story." It is building the standards, manufacturing base, and pilot demand needed to make projects financeable.
IndiaOn March 7, 2026, the Government of India announced notified standards for green ammonia and green methanol. The ammonia threshold was set at 0.38 kg CO2e/kg NH3.This is a major update to the old article. Indian P2X is no longer only a green hydrogen conversation. Derivative compliance is now becoming legible.
JapanOn September 30, 2025, METI approved the first projects under Japan's support system that focuses on price differences under the Hydrogen Society Promotion Act.Japan is shifting from long-range import strategy to actual support-backed demand. For exporters, that makes qualification pathways much more concrete.
KoreaKorea's clean hydrogen power market continued taking shape through 2025 tenders, including a 3,000 GWh/year clean hydrogen generation bid and a separate winning project from the first clean hydrogen power auction expected to begin commercial operation in 2028.Korea remains a policy-created demand market. Bankable entry depends on certification fit and power-sector qualification, not generic hydrogen supply.

The Real Bottleneck Is Bankable Demand

In 2025 the industry still talked about electrolyzer scaling as if supply-side cost decline would solve everything. It will not.

The harder problem in 2026 is matching five clocks:

  • the buyer's procurement clock,
  • the developer's permitting clock,
  • the lender's diligence clock,
  • the power contract clock,
  • and the policy clock.

That is why many announced projects still stall. The technology may be available, but the timing stack does not close.

For most projects, the winning pattern is now clearer than it was in November 2025:

Choose one beachhead market

Projects that begin by promising hydrogen, ammonia, methanol, SAF, domestic sales, EU exports, and Japan optionality all at once usually have not finished demand discovery.

Start narrower:

  • one molecule,
  • one lead market,
  • one main revenue stack,
  • one compliance architecture.

Optionality can be added later. Bankability usually cannot.

Design the carbon math from day one

This is the biggest practical change from the old article.

A project should now know, before heavy engineering starts:

  • which emissions boundary matters,
  • how renewable electricity is evidenced,
  • what data granularity buyers or schemes require,
  • how mass balance or chain-of-custody is handled,
  • and how the evidence will survive third-party review.

This is not a documentation problem at the end. It is a design problem at the beginning.

Derivatives are no longer a side note

For many export projects, shipping hydrogen directly is still the weaker commercial case. The more serious conversation is increasingly about derivatives:

  • Green Ammonia where fertilizer, marine fuel, or import terminal logic exists,
  • methanol where a credible biogenic or captured CO2 source exists,
  • and direct Green Hydrogen mainly where captive use or short logistics chains are available.

That is why India's March 2026 derivative standards matter so much. They bring the policy conversation closer to how many real P2X projects will actually monetize.

Digital MRV is now project infrastructure

The old article treated Certification as an important requirement. The 2026 version is stricter: it is project infrastructure.

If data, metering, reconciliation, and audit trails are weak, the project may still operate. But it will struggle to access premium markets, subsidy-linked demand, or export contracts.

What a Financeable P2X Project Looks Like in 2026

A credible project now tends to have six characteristics:

  1. A named buyer or auction pathway before major engineering spend.
  2. A renewable power strategy that already fits the target market's compliance logic.
  3. A derivative choice tied to real logistics, not generic "export" language.
  4. A realistic path to FID, with EPC, permitting, and contingency addressed together.
  5. A digital evidence stack for Carbon Intensity, Traceability, and audit.
  6. A management team willing to narrow scope instead of maximizing narrative.

That sounds less exciting than giant pipeline announcements. It is also what gets projects built.

Bottom Line

The original November 7, 2025 article argued that P2X projects are long, capital-intensive, and easy to underestimate. That part was right.

What changed by March 10, 2026 is that the market finally has sharper signals. Europe is allocating subsidy-backed production. H2Global has moved beyond the pilot stage. India has added derivative standards to the conversation. Japan and Korea are turning import ambition into specific demand mechanisms. And the global pipeline is being filtered much harder by real FID discipline.

That makes this a better market for serious developers and a worse market for vague ones.

If you are building for GHCI, RFNBO, Japan, or Korea, the competitive edge is no longer just cheap power or low electrolyzer cost. It is the ability to make compliance, offtake, and finance close as one system.

Selected Sources

  • Hydrogen Council, Global Hydrogen Compass 2025
  • IEA, Global Hydrogen Review 2025
  • European Commission and CINEA updates on the European Hydrogen Bank and Hydrogen Mechanism
  • Hintco updates on the second H2Global auction
  • Government of India and PIB updates on GHCI, mission allocations, and March 2026 derivative standards
  • METI updates on Japan's Hydrogen Society Promotion Act support approvals
  • MOTIE updates on Korea's clean hydrogen power bidding market

Working on a project that needs to be export-ready from day one? Talk to HyGOAT about building the compliance and traceability layer before FID instead of after it.
